Frank Road at Brown Road, Hardy Parkway Street, and Brown Road (Township)

A progress bar with three stages: IN DESIGN, UNDER CONSTRUCTION (highlighted with a check mark), and COMPLETE (greyed out). The process is currently at the UNDER CONSTRUCTION stage.
Construction of two multi-lane roundabouts at the existing intersections of Frank Road at Brown Road (County) and Hardy Parkway Street and at Brown Road (Township).

PROJECT TYPE:

Highway

COST:

$8,924,851.03

BEGIN CONSTRUCTION DATE:

2/9/2026

FINAL COMPLETION DATE:

5/28/2027

MAINTENANCE OF TRAFFIC:

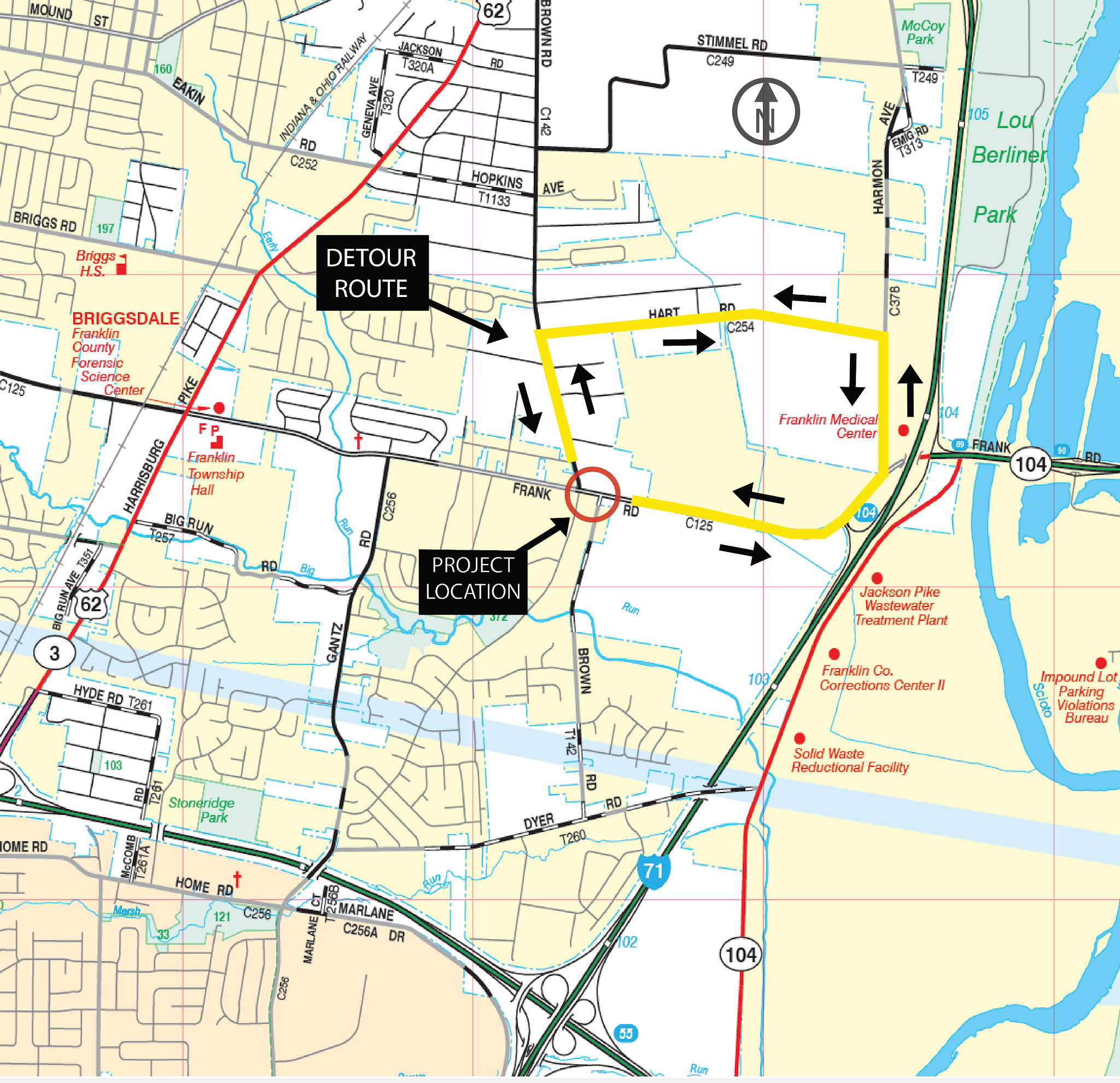

  • Maintaining 1 lane in each direction on Frank Rd throughout construction, with independent closures of each side street being required.
Phase 1 (90-days): North Leg

Phase 2 (30-days): Center

Phase 3A (45-days): South Leg

Phase 3B (10-days): South Leg at Certified Oil Driveway

Phase 3C (30-days): Hardy Parkway Street

Phase 4 (35-days): Frank Road splitter islands, intermediate course, center islands

Phase 5 (10-days): Final surface course, striping, signage

FUNDING:

["Ohio Department of Transportation (ODOT) Safety Funds","Ohio Public Works Commission (OPWC)","Motor Vehicle Registration and Gas User Fees"]

DESIGN CONSULTANT:

EL Robinson

CONSTRUCTION CONTRACTOR:

Strawser Paving

CONSTRUCTION INSPECTOR:

Kurt Selkinghaus

CONSTRUCTION YEAR:

2026

LOCATION:

Frank Road at Brown Road, Hardy Parkway Street, and Brown Road (Township)

CONTACT INFORMATION:

Phone: 614-525-3030
Email: fracoeng@franklincountyengineer.org
