Cooke Road (Karl Road to Cleveland Avenue)

A progress bar with three stages: IN DESIGN, UNDER CONSTRUCTION (highlighted with a check mark), and COMPLETE (greyed out). The process is currently at the UNDER CONSTRUCTION stage.
This project involves 1.02 miles of improvements of Cooke Road from Karl Road to Cleveland Avenue. Improvements include a 10' wide shared-use path and 5' wide sidewalk along the length of the corridor, lane restriping, curb & gutter, drainage improvements, and corridor lighting from Walford Street to Cleveland Avenue.

PROJECT TYPE:

Highway

COST:

$6,563,449.82

BEGIN CONSTRUCTION DATE:

3/2/2026

FINAL COMPLETION DATE:

5/28/2027

MAINTENANCE OF TRAFFIC:

Phase 1 (75-days): 3/16/26 to 5/29/26
Phase 2 (75-days): 6/1/26 to 8/14/26
Phase 3 (75-days): 8/17/26 to 10/30/26

FUNDING:

Mid-Ohio Regional Planning Commission (MORPC) Funds, Ohio Public Works Commission (OPWC), COTA Transit-Supportive Infrastructure Funds, Motor Vehicle Registration and Gas User Fees, Community Project Funding

DESIGN CONSULTANT:

DLZ, Inc.

CONSTRUCTION CONTRACTOR:

Shelly & Sands

CONSTRUCTION INSPECTOR:

Tony McClendon

CONSTRUCTION YEAR:

2026

LOCATION:

E Cooke Road from Karl Road to Cleveland Avenue

CONTACT INFORMATION:

Phone: 614-525-3030
Email: fracoeng@franklincountyengineer.org

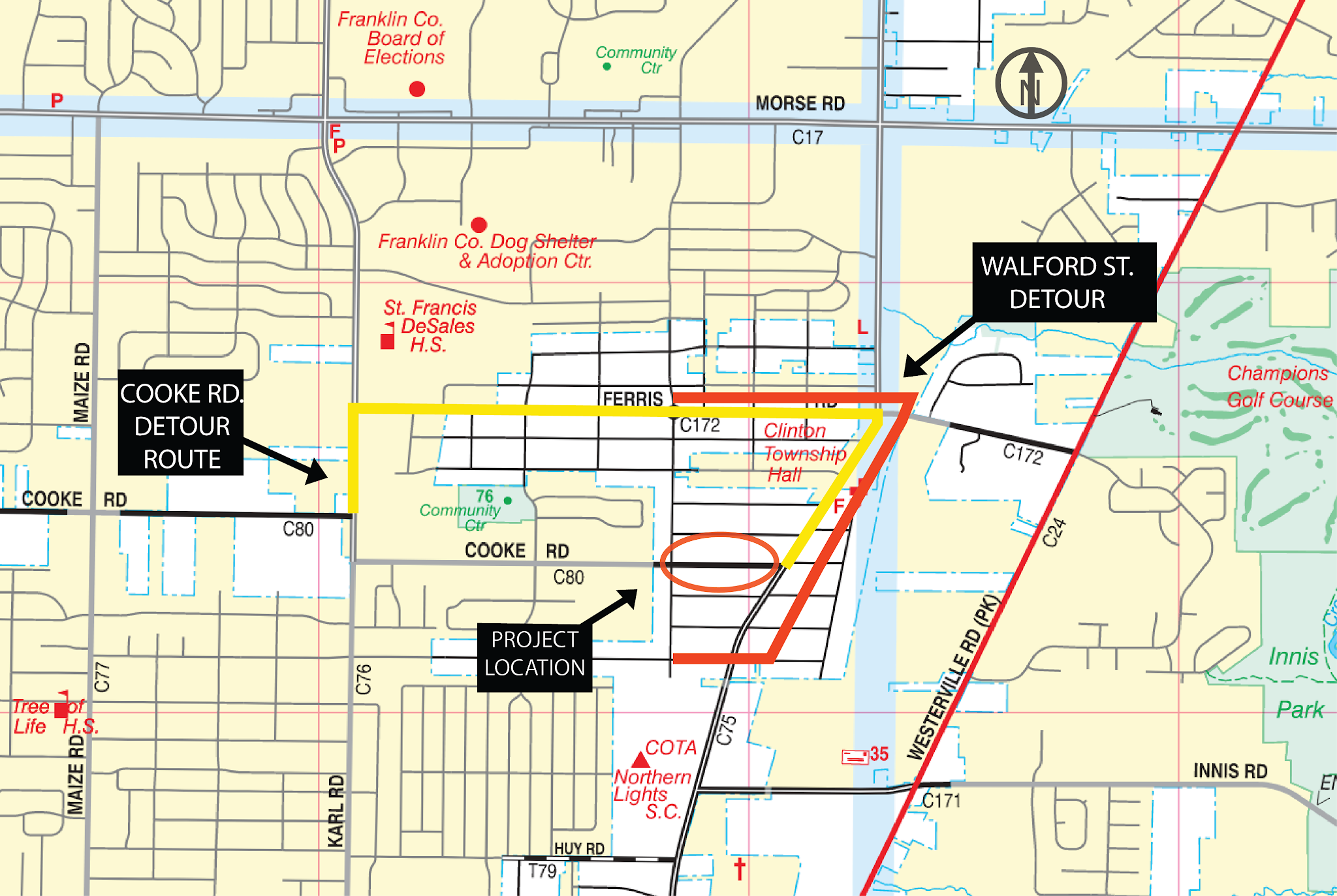

DETOUR MAP
